Skip to content
Reports

Operations reports for every site, by the day

See what was done on time, late or missed at each site, which checks fail, what is waiting on sign-off, and get the figures emailed on a schedule.

  • On time, late and missed, against each task's due date
  • Completion and daily compliance by site, worst first
  • Audit scores, flags and every submission, filterable and exportable
  • What is waiting on sign-off, on whom, and for how long
  • Emailed on a schedule, each copy narrowed to the reader's sites

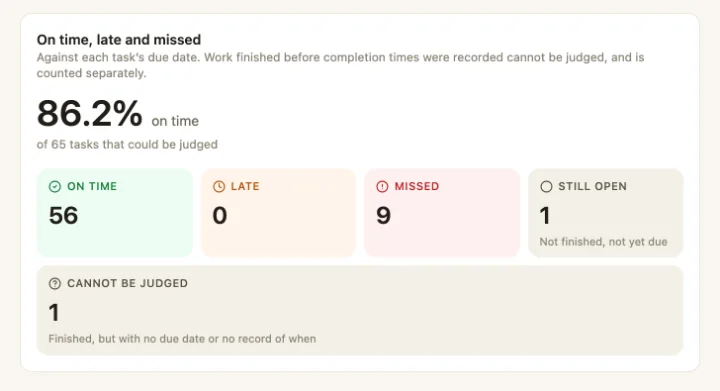

The On time, late and missed report: 86.2% on time of 65 tasks that could be judged, with 56 on time, none late, 9 missed, 1 still open, and 1 that cannot be judged because it has no due date or no record of when it was done.

Records are only worth keeping if somebody reads them. Most teams fill in the checks and never look back, because looking back means opening forty runs one at a time or rebuilding a spreadsheet every Monday. So the warm fridge at one site and the close that keeps getting skipped at another stay invisible until an inspector or a complaint finds them.

Reports read the same records your staff fill in on their phones, and answer the questions a manager actually asks.

One question per report

On time, late and missed

Against each task's due date. Work finished before completion times were recorded is counted separately rather than guessed.

Completion by site

Worst first. Cancelled work is left out, because it was withdrawn, not missed.

Daily compliance

Each site's own calendar day, so a day with nothing assigned looks different from a day where nothing was done.

Scheduled work

Per routine, worst first, with how long each one sat after it opened.

Audit scores

Per checklist, with the sections pulling each average down, which a total on its own can't show.

Flags

What is going wrong, where and how often, and how many are still open.

Site vs company

One site against every other, so a site that is slipping stands out from a hard week everywhere.

Work per person

What was on each person's plate and how much of it got done.

Submissions

Every run of a checklist in one grid, filtered by the answers given, and exported to CSV or Excel.

Photos

Every photo taken on a run, by site and date, without opening the runs one by one.

When a check fails

A failed answer shouldn't wait for someone to read a report. A checklist question can act on the answer as soon as the run is submitted. This one is from the Riverside demo:

  1. The check fails

    Daniel's opening check at Riverside Quay finds the front-of-house fridge at 7.9 °C and answers Fail.
  2. The fix is raised

    Submitting the run creates a corrective task, Fix: Fridge temperature within range, on the Front of House board for the Managers team, due in two hours, with the question and answer that raised it.
  3. Someone is told if it sits

    If the task is still open an hour later, Maya, who runs the group, gets Warm fridge still not fixed. If it was closed first, nothing is sent.
  4. It closes on the record

    Whoever fixes the fridge closes the task, and the task keeps a link back to the run that raised it. Corrective work has a due time, so if it runs late it counts as late like any other task.

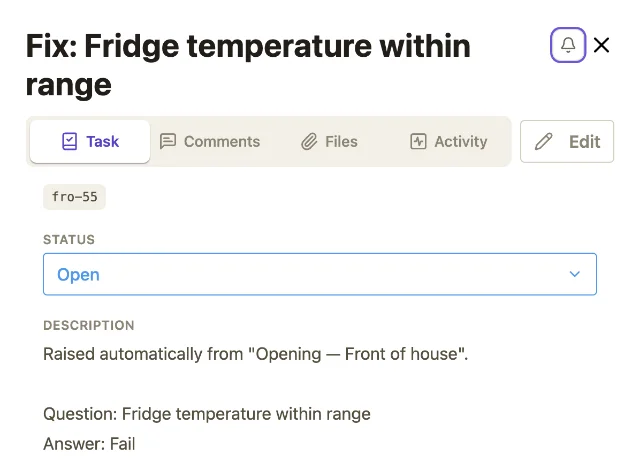

The corrective task a failed fridge check raised: Fix: Fridge temperature within range, still open, raised automatically from the Opening, Front of house checklist, with the question and its Fail answer.
The corrective task the failed fridge check raised, with the question and the answer that raised it.

Who is told, and after how long, is set per question, and the people are worked out when the escalation fires, not when the run was submitted. If it names a role or a team, it reaches whoever holds that role or is in that team an hour later. How to set this up is covered under checklists.

What is waiting on sign-off

The Approvals report: two checklists waiting for a decision since today, the three floor managers they are waiting on, and twelve approved and none rejected this period, with how long each reviewer took to decide.
Two cash-ups waiting for a decision, the floor managers they are waiting on, and who decided what this period, with how long they took.

The Approvals report ignores the date range on purpose. A submission that has been stuck since before the period started is exactly the one you need to see. It shows how long each has waited and who it's waiting on, next to the decisions already made. The approval chain itself decides who may sign off what.

Reports that arrive

A report someone has to remember to open gets opened in the week something has already gone wrong. Eight of the reports, from completion to flags, can be scheduled instead:

  • Daily, weekly or monthly, at a set time in the timezone you choose, so it stays at 7am through the clock change.
  • To people, teams, roles or a whole site, with a preview of exactly who would get a copy before you save it.
  • One copy per reader's sites, or the same figures for everyone. With the first, one schedule serves every area manager, each seeing only their own sites.
  • Figures in the email, with an optional link to the rows behind them that expires.

What the numbers can and can't tell you

A report counts what was recorded: when, by whom, and what was answered. It can't tell you a fridge was really cold, only that someone read it at 4.1 °C at 07:12 and attached a photo. That is still far more than a ticked column, and it shows you which sites and which checks to go and look at in person.

Where reports fit

Reports sit at the end of the loop. The rota says who was working, schedules create the work, checklists record how it was done and approvals sign it off. Reports show where any of that slipped, by site, without anyone collating it. For audits and inspections, see compliance evidence.

FAQ

Reports, in practice

What does operations reporting software need to show a manager?
What was due and what happened to it: done on time, done late, or missed, by site and by day, with the failures and the work still waiting on someone. In EasyBee the figures come from the same records staff fill in on their phones, so nobody collates a spreadsheet at the end of the week.
How does corrective action tracking work?
A checklist question can raise a corrective task when it is answered a certain way, assigned to a team with a due time and the answer that raised it attached. It can also set an escalation: if the corrective task is still open after the delay you choose, the people, team or role you named are told. If the task was closed first, nothing is sent.
Can multi site compliance reports be emailed automatically?
Yes. A report can be scheduled daily, weekly or monthly at a set time, to people, teams, roles or everyone at a site. Each schedule decides whether everyone gets the same figures or each copy is narrowed to the sites its reader belongs to, so one schedule serves every area manager. The email carries the figures, and can carry a link to the rows behind them.

What was done, missed or still waiting, at every site

Set it up with your own team and see it running this week. No card required.
